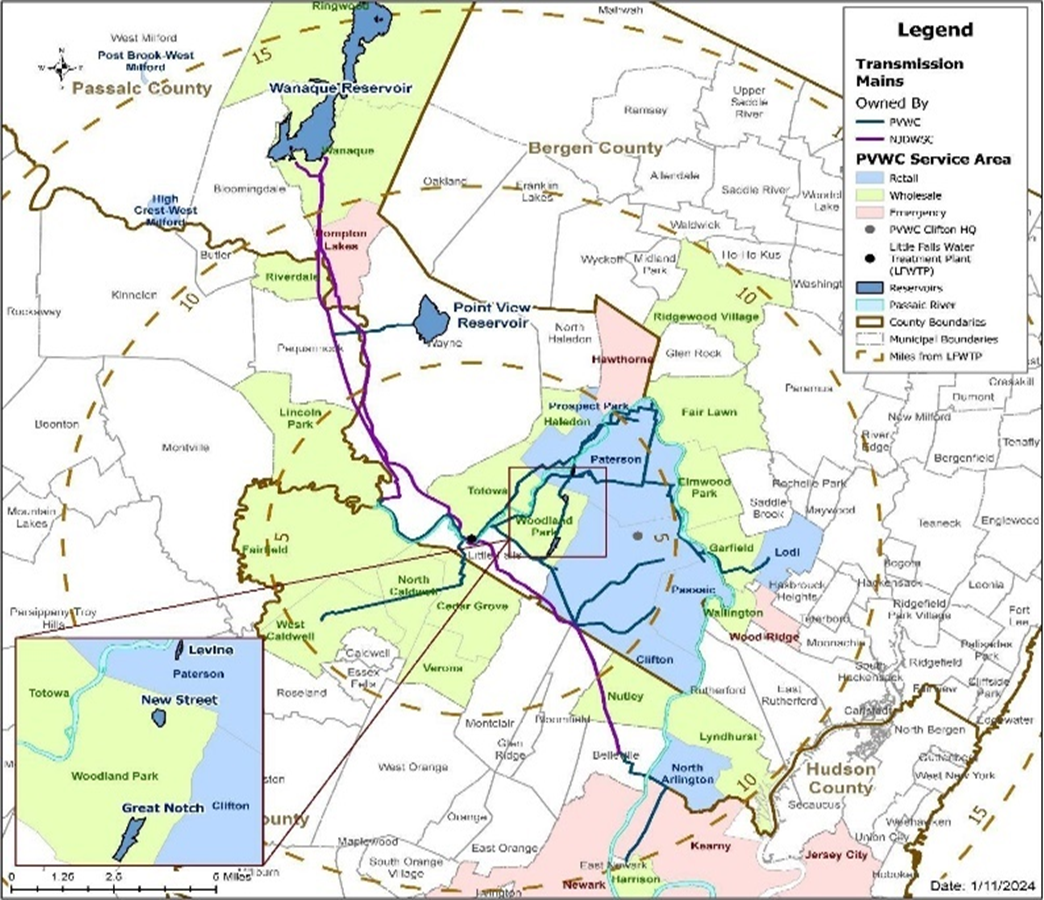

PVWC’s capital assets span eight (8) retail areas and 23 wholesale areas serving a population of 800,000 people across 77,000 metered accounts. Key asset highlights include: 650 miles of transmission and water mains; an 80 million-gallon-per-day (MGD) central water treatment plant; 125 million gallons (MG) of usable storage in three (3) uncovered, finished water reservoirs; five (5) dams; and administrative office space for 247 current staff as well as storage facilities for equipment and material located in Clifton, Little Falls and Point View Reservoir.

In 2025 the capital budget was $880M from 2025 - 2030 across the following categories of infrastructure investment:
- Water Storage Program
- LSLR/Material Procurement/ Vehicles/Meters/Buildings & Grounds
- Transmission/Water Mains
- Treatment and Pumping
- Digital Transformation
Below are highlights of ongoing construction, design and planning projects related to the PVWC capital program.
Water Storage Program
Levine Reservoir

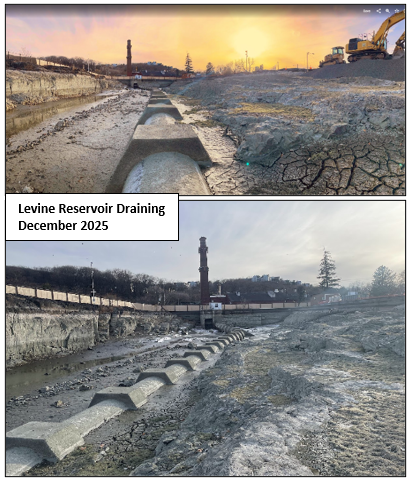

In May 2025 construction officially commenced on the installation of two (2) 2.5 MG storage tanks to replace the Levine reservoir for $42M. Site preparation work commenced in June and in December draining of the reservoir commenced in advance of construction of the dividing wall. This wall will segment the site into a smaller open water reservoir that will be put back into service by February 2026 while the north side of the site is prepared for tank construction.

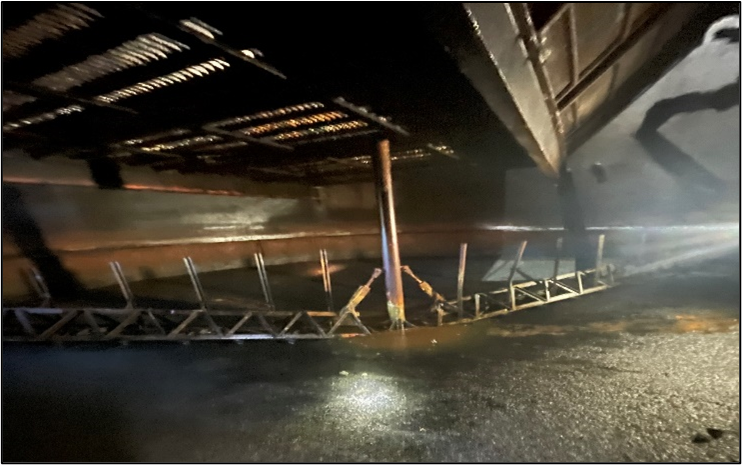

In addition, on October 17, 2025 upon detailed inspection of the inlet line to the reservoir it was found that 1,000 linear feet (LF) was in severely deteriorated condition and PVWC declared an emergency to address the issue. A $2.1M change order was approved to the Levine construction contract to provide “emergency services” for full pipe replacement of this section of pipe. Completion of the entire storage tank project is projected for May 2027.
Great Notch and New Street Reservoirs – Distribution and Storage Planning

Great Notch and New Street reservoirs will have storage tanks constructed over a longer time period due to the scale and sequencing of the work and competing needs of other capital priorities for PFAS removal, upgrades to main pumping station, and investments needed in transmission mains and water mains to allow the system to operate normally when reservoirs are out of service. PVWC will need to submit a comprehensive planning report by May 1, 2028 to State and Federal regulators that will identify all necessary projects that will bring PVWC into compliance with the LT2 Rule. Based on the current unit cost of Levine of $8/gal and forecasting construction costs over time for Great Notch and New Street at $4-5/gal considering economies of scale + cost escalation, with targeted storage amounts of 75 and 60 MG respectively, total costs for these projects are in the $500-700M range. We are currently working with Arcadis (Distribution and Storage Planning) and Black & Veatch (PFAS Planning) to develop a prioritized, integrated capital projection to address mandates and state-of-good-repair needs over the next 30 years. A preliminary projection is shown on the next page. This will be refined over time focusing on the next 5-10 years and then looking out over a longer 30-year horizon. Concepts being explored include sequencing work in phases to spread costs out over time, and phased PFAS treatment tailoring different technology to different parts of the system to match specific characteristics.

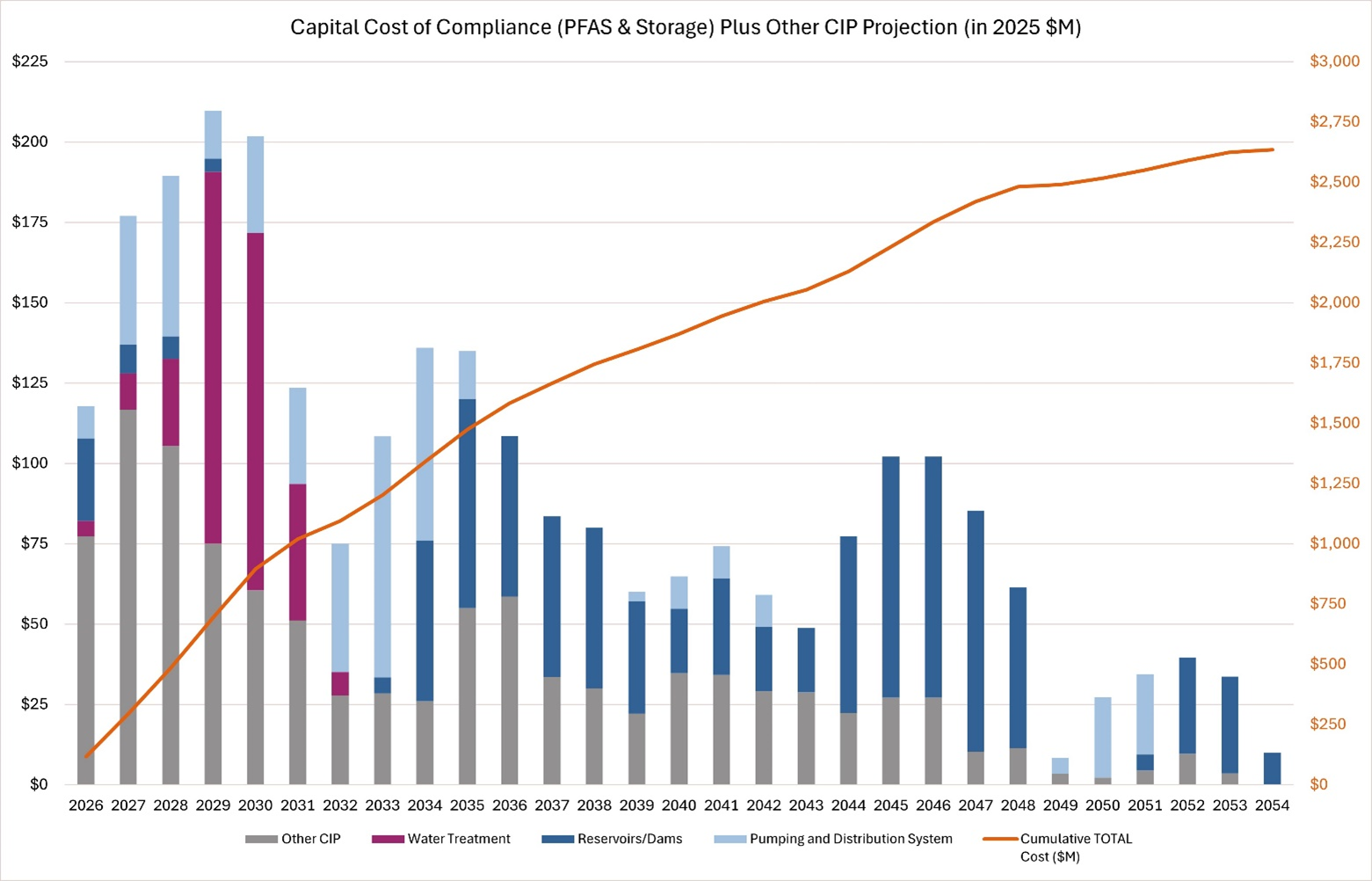

Preliminary Conceptual Capital Forecast

The forecasted capital investments are front loaded over the next 5-10 years due to new regulatory requirements for PFAS as well as key infrastructure reaching the end of its useful life at the same time. This includes the 120 MGD main pumping station at the treatment plant and associated intake and outflow pipelines that are over 100 years old. Transmission main and water mains in the distribution system have similar capital needs across the 650-mile pipeline system with almost 60% approaching 100 years old and some nearing 140 years of age. In the mid-2030’s water storage mandates that have been deferred over the last decade begin implementation at Great Notch reservoir followed by New Street. These storage projects are being included in a new consent decree allowing a longer implementation timeframe in recognition of other competing needs for regulatory compliance and state-of-repair investments. Additional opportunities for principal loan forgiveness through the State Water Bank for the final LT2 projects, PFAS upgrades and pre-cursor projects will be a key factor in program execution.
Interim Water Quality Improvements

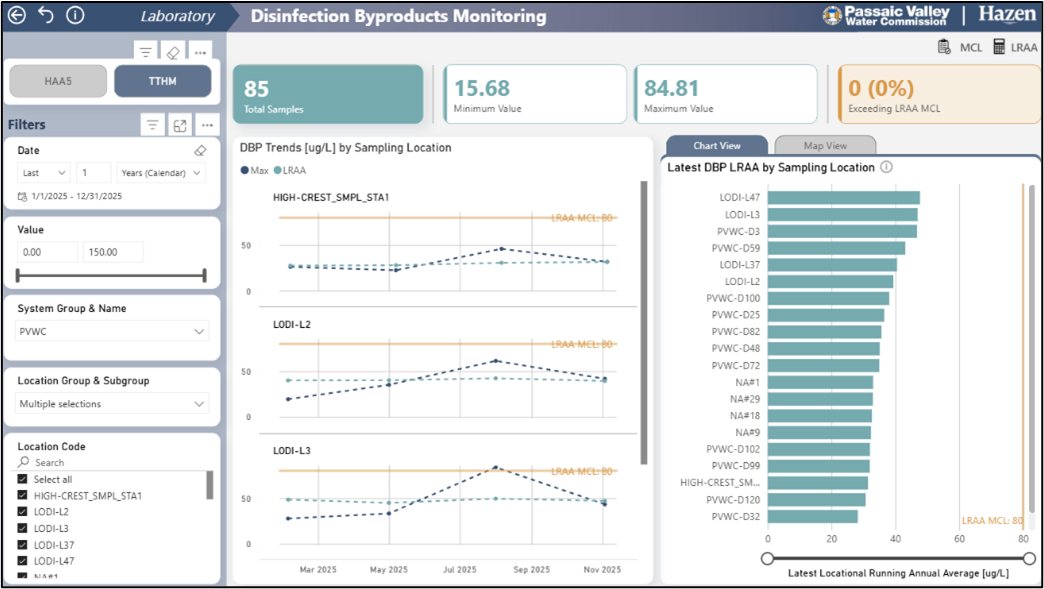

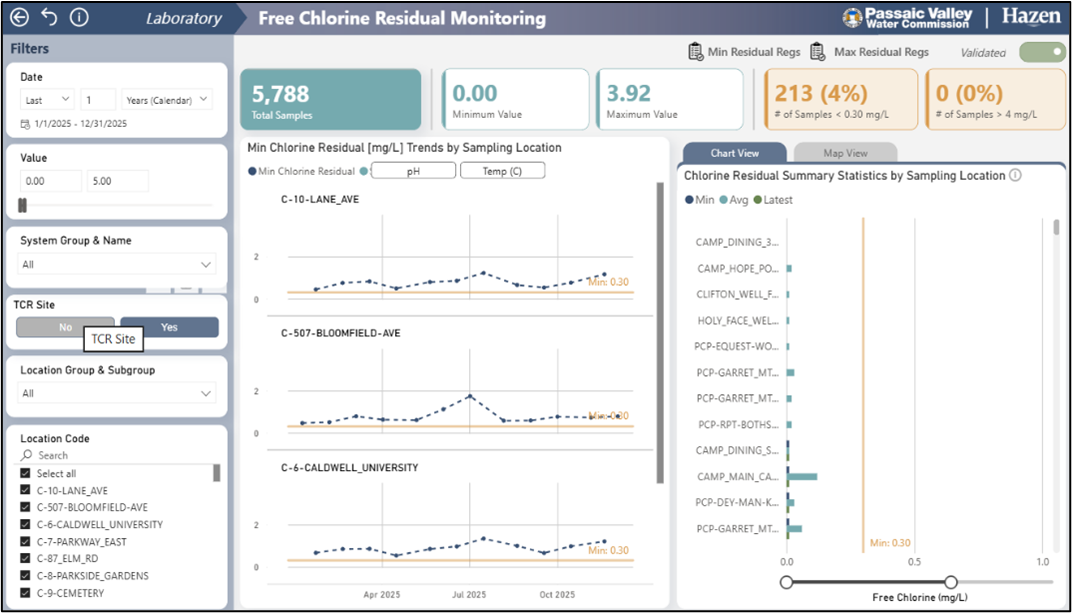

While covering the Great Notch and New Street reservoirs will be a long-term endeavor, PVWC performs extensive monitoring in the distribution system for pathogens and free chlorine to ensure the protection of public health. In 2025 there were 5,788 free chlorine samples taken with almost 98% of the results above the minimum requirement of 0.2 mg/l. There were only five (5) positive coliform samples for 2025, and the PVWC protocol is to flush and resample to make sure there is no threat to the public.

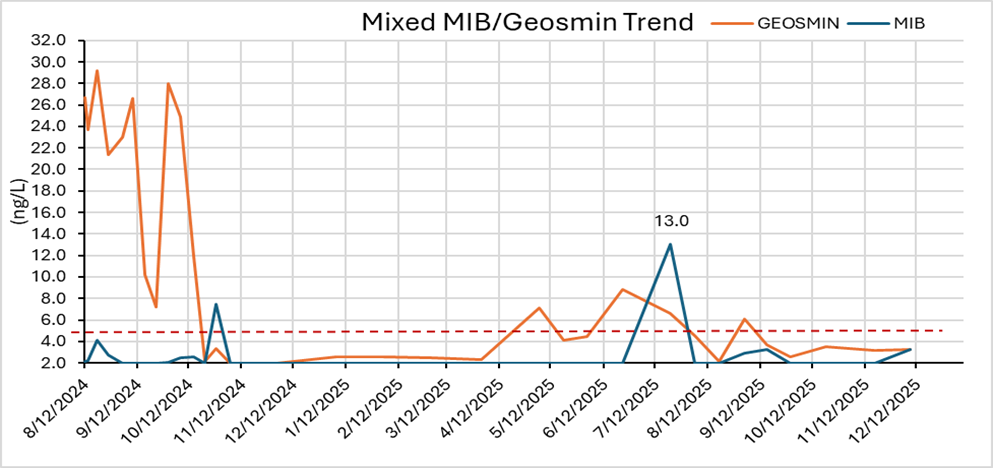

In addition, to pathogens, PVWC is investigating additional interim water quality improvement measures to reduce discolored water and nuisance algal blooms like MIB and Geosmin as well as iron and manganese that can impact taste, odor and color. Sampling is planned from November 2025 to March 2026 and pilot testing of various technologies is planned from March 2026 to September 2026 to address these issues. Katherine McNaught, Manjistha Chattopadhyay and Wendy Simone in the PVWC Lab are working closely with Arcadis staff to identify technologies to deploy and pilot test in the coming months to minimize taste, odor and color issues.
Lead Service Line Replacement
Main System – Paterson, Clifton, Passaic, and Prospect Park
The contract with CDM-Smith for CM and service line inspections began in the Spring 2022 and the construction contract with Pacific Construction (Contract 22-B-8) started in July 2022. The overall program is being funded through the State Water Bank with a loan amount of $37.6M which includes construction, CM, and administrative costs to PVWC. We have received a commitment of principal loan forgiveness ($27M) from the NJ I-Bank. The contract has expired as of October 31, 2025 and the long-term loan with principal forgiveness is expected to close by mid-2026.
There are 212 customer-owned lead service locations that were non-responsive to repeated PVWC and contractor outreach. Currently PVWC’s inhouse distribution group is working on a plan to address these locations with support from other existing contracts as warranted.

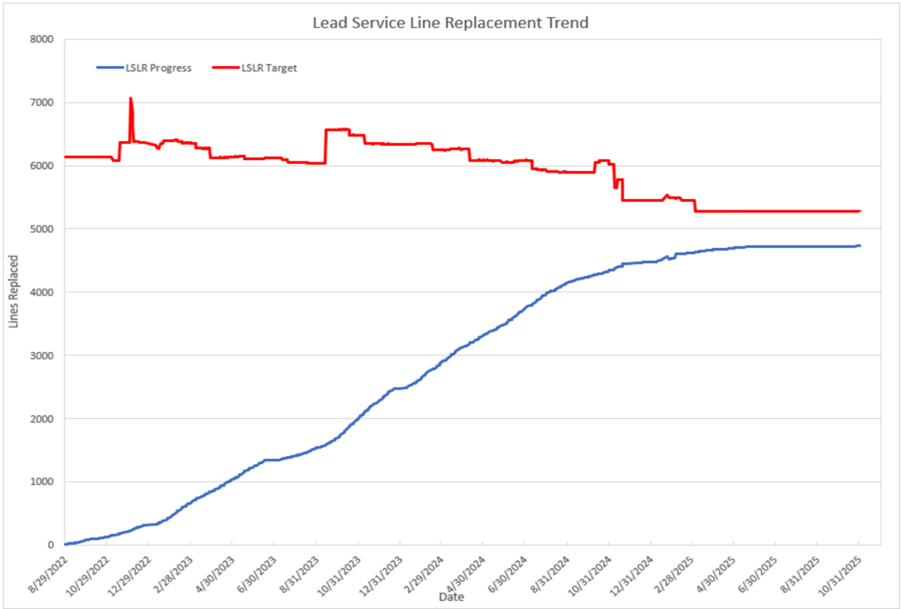

Special thanks to Alex Wells, Supervising Engineer and her team for managing the contract to completion, Maria Malfa and her Customer Service team for contacting customers, as well as Mike Marotta and the Distribution team for developing a plan to close out the last 212 non-responsive customer locations. In total there were 4,722 lead service lines replaced under this program for free for customers making the main system essentially lead-free from the street to the water meter at the home or business.
North Arlington and Lodi

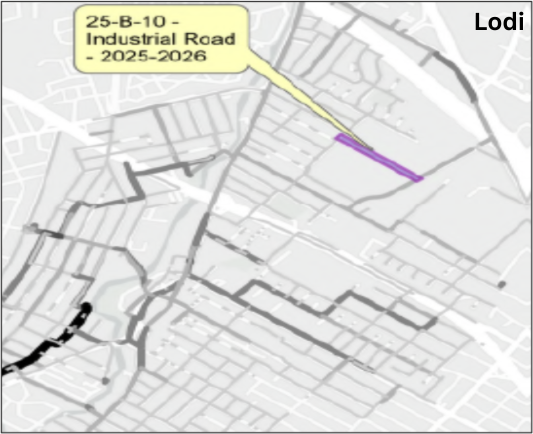

By 2031, the rest of the PVWC retail areas are required by NJDEP to have all customer-owned lead service lines removed by the company. In 2025 the forecasted budget for this work is $20M for Lodi and North Arlington. Work is forecasted to start in 2028 and be completed by 2031. This work may be accelerated if opportunities are identified to maximize principal loan forgiveness from the NJ Water Bank or if other become available.
Material Procurement and Meters
Last year PVWC inhouse crews responded to 139 water main breaks with skill and efficiency. To support our crews we budget almost $10M annually for material procurement to ensure we have what we need to effectuate repairs cost-effectively and ensure water keeps flowing to our customers. There was also $23.3M budgeted through 2030 for meter replacements. In house meter crews replaced over 3,700 meters in 2025 and there were two construction contracts awarded in 2025 to install up to 20,000 meters in the Main System. These contracts will be funded with 100% principal loan forgiveness up to $7M. We will look to plan more proactive inhouse work to replace vulnerable pipes and meters more comprehensively that have reached the end of their useful life. Additional contracts will be advertised over time for meter replacements to leverage principal loan forgiveness opportunities.
Transmission and Water Mains
As stated previously there are 650 miles of transmission and water mains in the PVWC system and almost 60% are nearing 100 years old or greater with some nearing 140 years old. There have been limited capital investments to upgrade the distribution system for the last 50 years and due to the age of the system there is a need to catch-up on replacing these pipes. In 2025 there is almost $220M budgeted for transmission and water main upgrades in the PVWC retail areas through 2030. This includes stand-alone projects, emergency contracts, professional design and construction management services, and road paving for inhouse water main replacement work that we are ramping up over time.

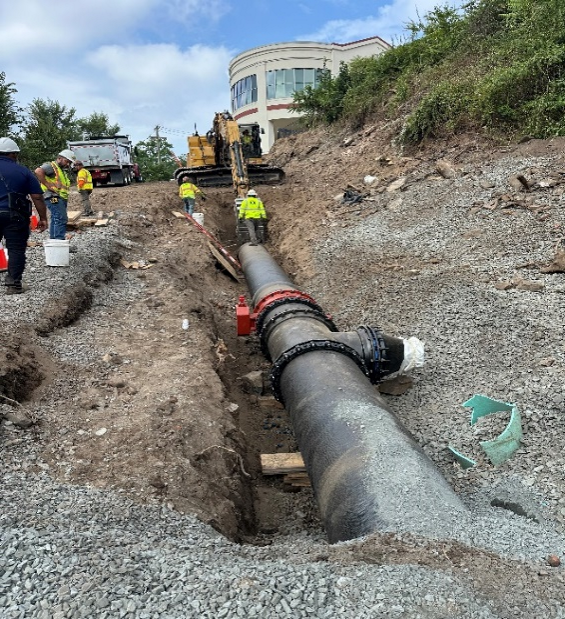

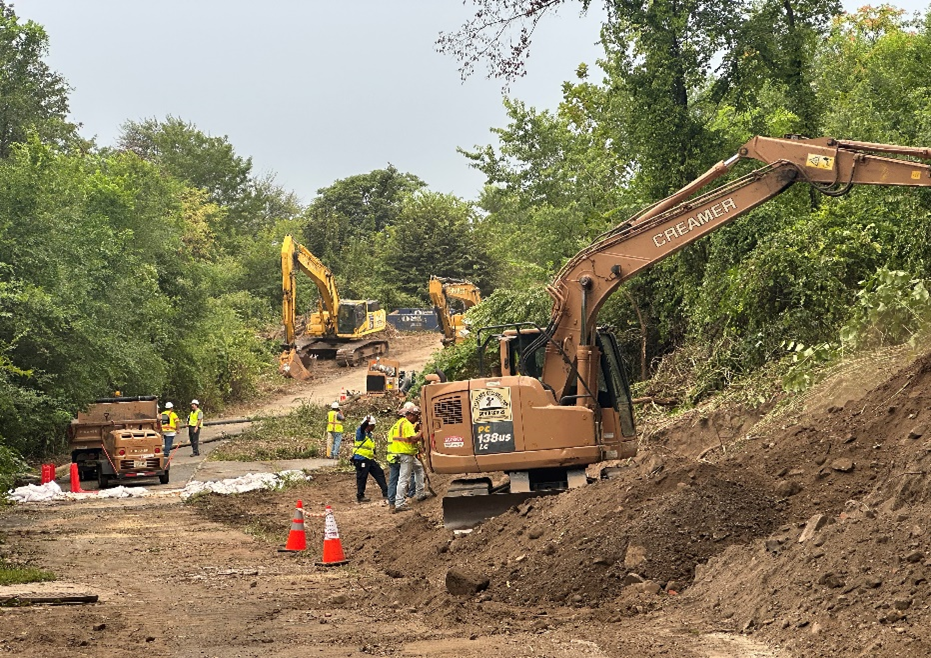

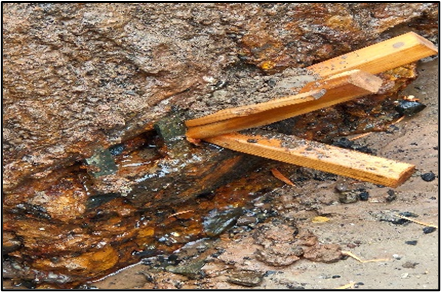

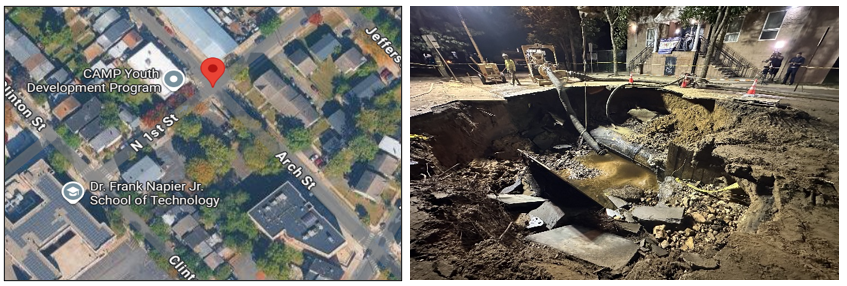

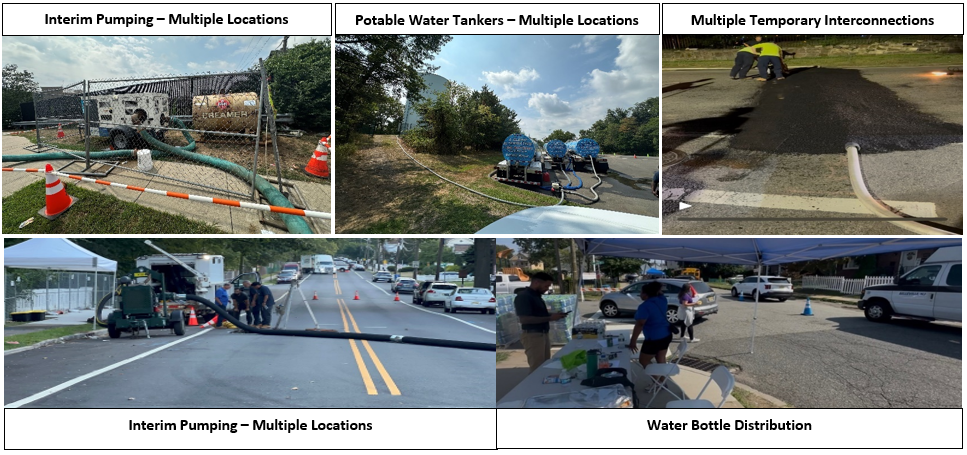

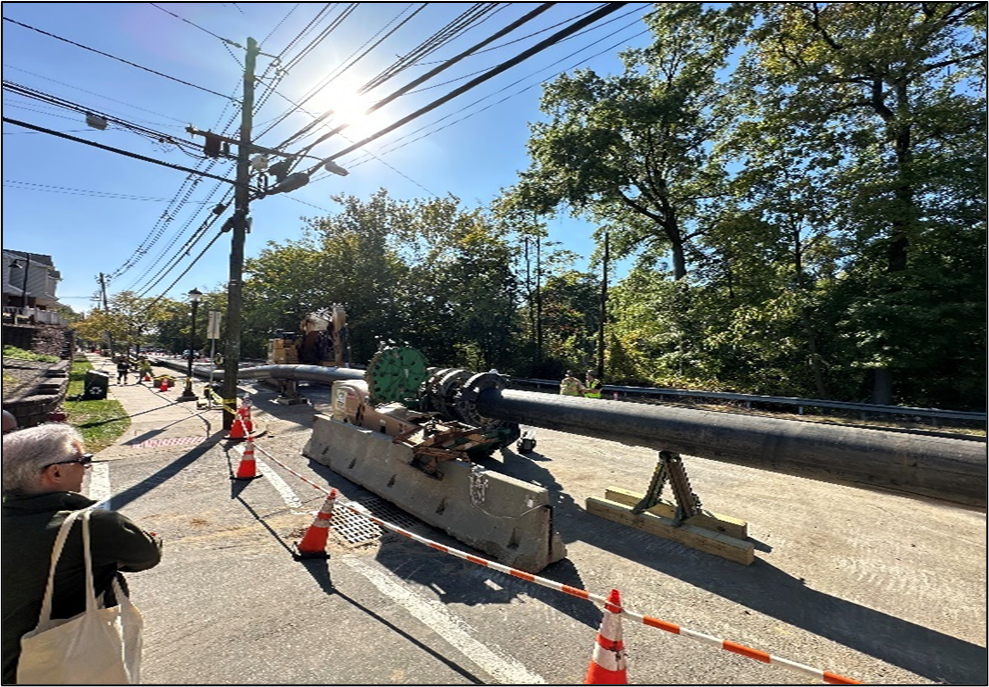

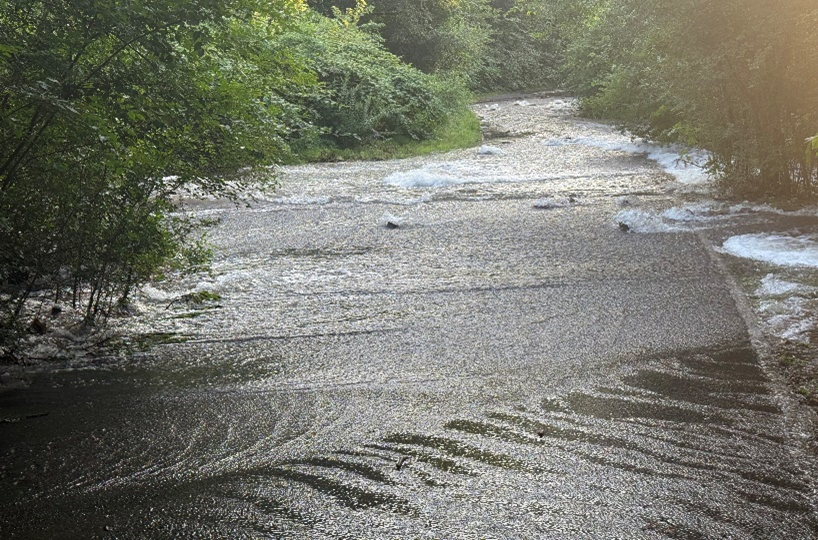

During the response to the Hinchcliffe water emergency in August 800 LF of 30” and 24” pipelines were replaced on the hill adjacent to Hinchcliffe stadium. We will be bidding a project for Great Falls in Q1 2026 to upgrade the transmission mains at the top of the hill in Mary Ellen Kramer Park to modernize the pipelines on the whole site. This will be key to minimize risk and, combined with the 1000 LF being upgraded at Levine reservoir, progress PVWC towards connecting key regional areas in PVWC’s system with new pipes. There remains about 1/4 mile of pipes between Levine and Great Falls that would need to be addressed in a successive phase when priorities and funding allows.

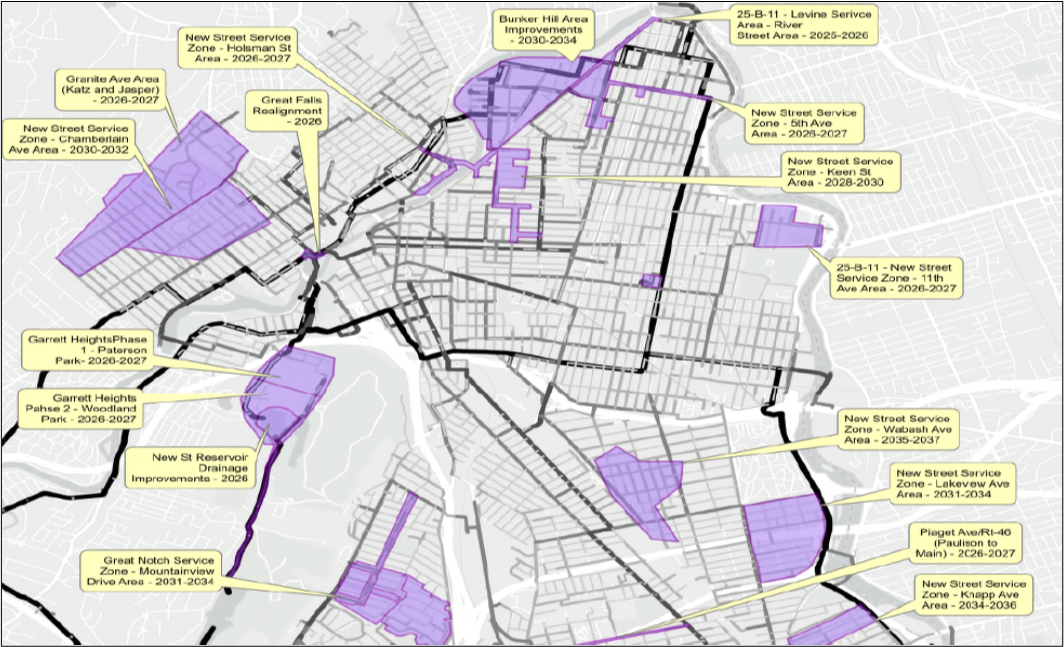

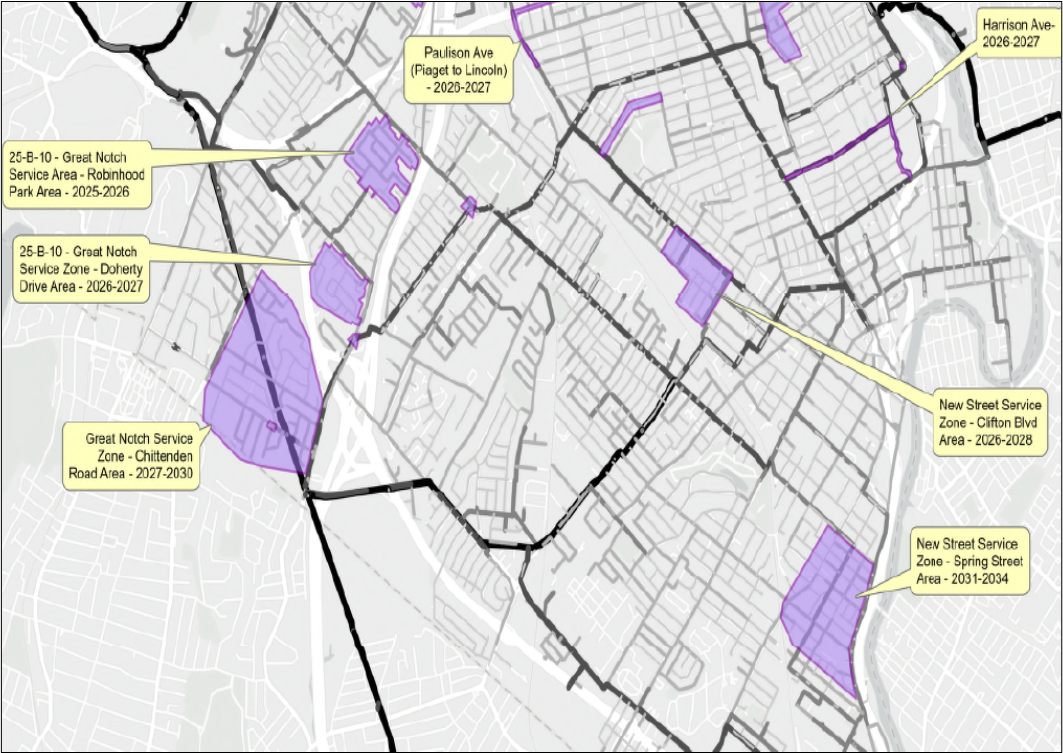

Below are maps illustrating the key stand-alone projects followed by a table listing key details of each project. These projects have been prioritized due to water main break history, criticality and coordination with planned work in Passaic County and the owner cities.
Treatment and Pumping
PFAS Planning and Basis of Design
In April 2024, USEPA promulgated new regulations for PFAS water quality limits lowering the maximum level to four (4) parts per trillion (ppt). The Little Falls Treatment Plant will not comply with these new limits and PVWC entered a contract in September 2024 with Black & Veatch to develop a facility plan and basis of design as a pathway to compliance. All relevant data have been provided and a short-list of alternatives has been developed. The optimum path for the upgrade would be to maximize space down by the existing filters for new post-filter, gravity contactors with granular activated carbon (GAC) media. However, there is not enough space to maintain current plan flows of 80MGD with that technology and as a result this alternative does not appear realistic. Moving the PFAS treatment process to the top of the treatment site, near the White House (see site plan below), where there is space seems to make the most sense. The need for modernization of the existing pumping station is a complicating factor, and this work is a priority due to the age of the pipes.

Currently the compliance sampling period is scheduled to start in 2027 two (2) years ahead of the 2029 compliance date. This schedule does not give PVWC enough time to adopt and implement a treatment strategy to remove PFAS and comply with new limits. The recent Federal proposal to allow an additional two years to the compliance schedule moving it from 2029 to 2031 is extremely helpful. It remains to be seen if the State of New Jersey will adopt a more stringent compliance schedule. This additional time will assist PVWC in further developing alternatives for compliance and initiating upgrades in the next four (4) years with monitoring starting in 2029 ahead of the proposed 2031 date.

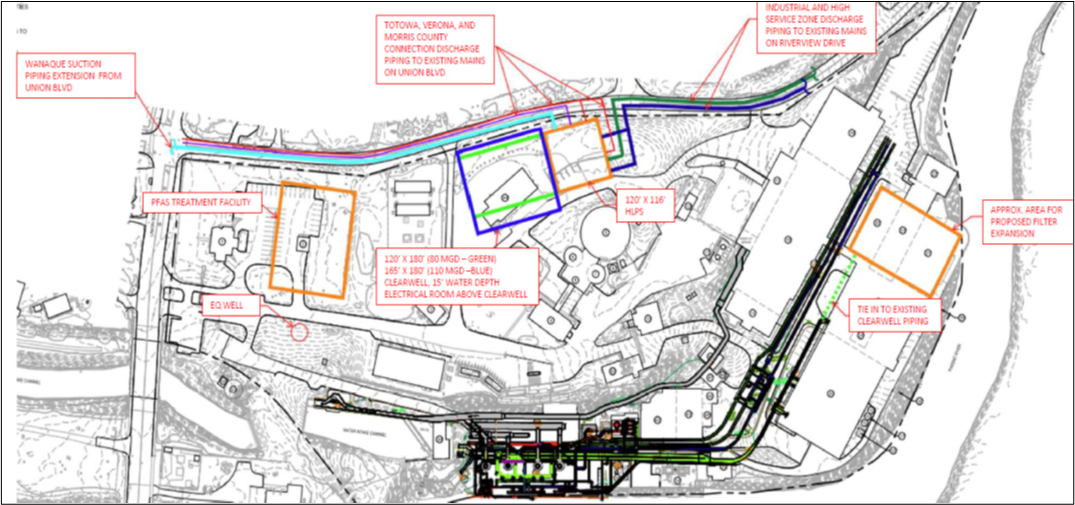

A site visit was conducted in October to Cape Fear, NC to walk through their current PFAS technology of post-filter, gravity contactors with GAC. In addition, a prioritization meeting was held in November 2025 with PVWC, Black and Veatch and Arcadis to sort through the competing needs of water storage, PFAS and other state of good repair needs. To maintain a pathway to compliance with the 2031 date, we intend to finalize our plans for PFAS in the first half of 2026 and develop a phasing plan consistent with plant and system priorities as well as funding constraints.
The State of NJ reached a state-wide settlement with 3M, a major manufacturer of PFAS material, for $450M. It remains to be determined what amount, if any, of this settlement will be made available to utilities to assist in funding treatment upgrades to comply with the new compliance targets.
State-of-Good Repair Projects – Construction
Actiflo Rehabilitation ($4.8M across two contracts)
Coppola Services continues work on the Actiflo rehabilitation. Coating operations have commenced on the first Actiflo train, which is anticipated to return to service toward the end of January 2026. Upon completion, the contractor will take the second train offline to begin the next phase of rehabilitation. The overall contract work is scheduled to be completed by Fall of 2026 under the original 2-year contract awarded in September of 2024.

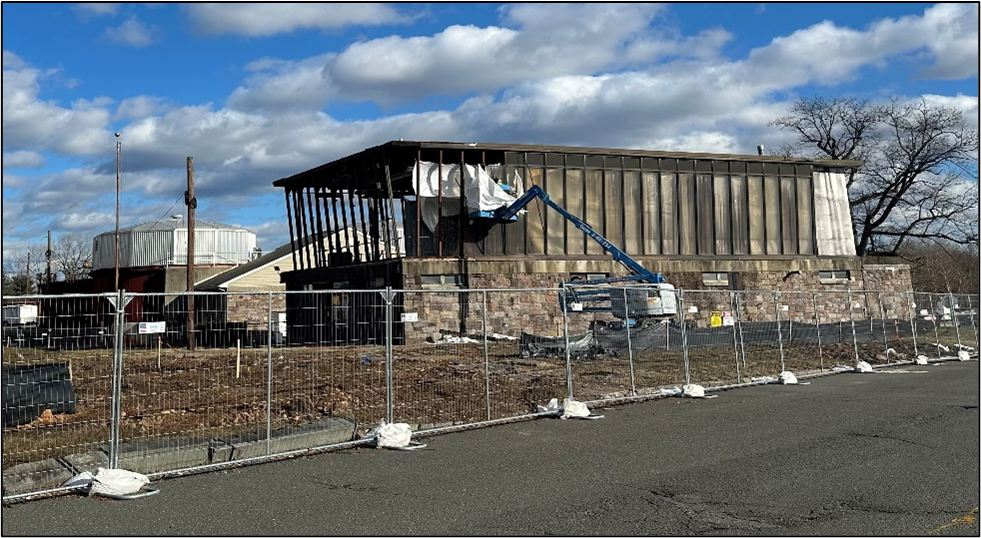

Residuals Facilities Upgrade ($31.2M)
Coppola has begun asbestos remediation within the former Belt Filter Press building. Once remediation is complete, the structure will be demolished to allow construction of the new residuals processing facilities to proceed. Inhouse staff are installing a new water line to the building that is nearing completion so water service can be maintained to other parts of the plant. The work is scheduled to be completed by March 2028.
Filter Valve Replacement Project ($7.9M)
The contractor is progressing with shop drawing submissions and developing sequencing plans to safely isolate filters for valve replacement work. During a recent plant shutdown, Coppola measured the filtered water conduits to support fabrication of new stop logs. The work is scheduled to be completed by September 2027.
State-of-Good-Repair Projects - Design
There are also ongoing designs for upgrades to the liquid oxygen (LOX) system and chemical addition facilities. The influent gates, and influent screens are also being assessed for upgrades. These projects will be prioritized for funding based on risk-based business cases.
Digital Transformation
As part of the approved 2025 budget there is $30.9M allocated for capital investment in PVWC digital transformation initiatives between 2025 and 2030 involving both information technology (IT) and operational technology (OT). These investments cross different infrastructure areas of focus with some investments already underway and others ramping up over the next few years. These focus areas are categorized as follows: security/cybersecurity; hardware; document management; emergency back-up; asset management; business intelligence; communications; and system modernization. The table below includes the capital budgeted in each focus are by fiscal year.

Early priorities in 2025 include modernizing the financial management system (FMS) and fleet monitoring technology; further developing a data governance framework for the new enterprise data warehouse and optimizing CMMS/GIS/CIS for business intelligence; communications improvements for fiber optic cables, cellular systems; telephones and website; and hardware replacement due to antiquated equipment. In 2026, investments ramp-up for facility access control upgrades for building security as we also prepare plans and designs for a data center to be implemented towards the end of the decade. Steady annual investments are also planned for document management to preserve institutional knowledge and make staff access easier to critical, secure information; as well as improve the inventory and plan for system upgrades for SCADA hardware and software due to equipment modernization needs.

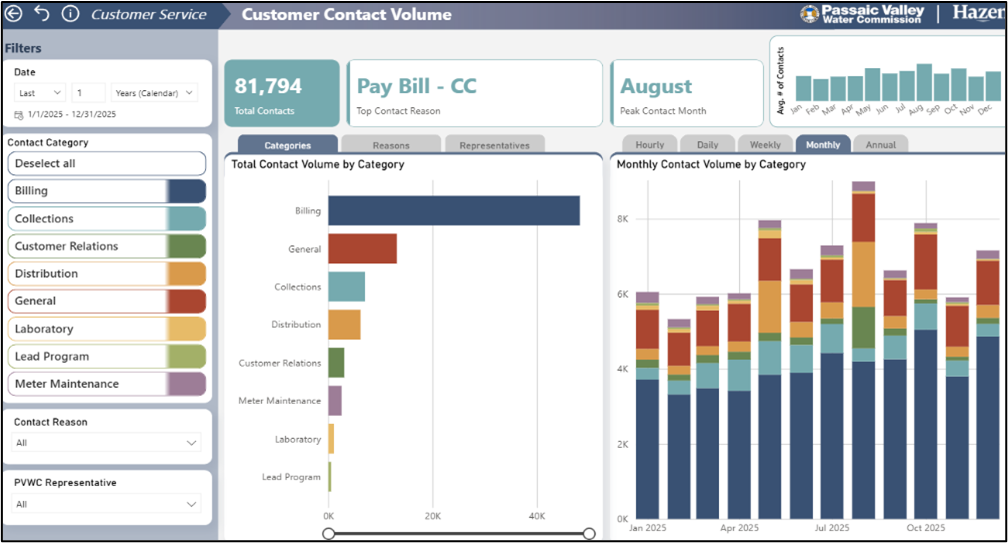

Other Initiatives
Systemwide Valve Exercising Program
A concerted effort has been made to exercise and note deficiencies of all of the valves in the PVWC system. By the end of 2025 our contractor had assessed almost 4,000 valves in the system. Approximately 1/3 of the valves had documented issues that either were addressed in the field or need to be prioritized for inhouse replacement or capital projects.
Transmission Main Acoustic Leak Detection Inspection
After months of preparation for PVWC’s first inspection of a transmission main, including the installation of taps, valve inspections, and flow tests, Pure Technologies completed an internal acoustic leak inspection on June 25th, 2025. We inspected approximately 18,000 LF of the 42” concrete lined, steel pipe using the SmartBall technology.
At a workshop in November, I requested the PVWC engineering team and design consultant teams to develop a toolbox of options for leak detection across the 650-mile-long distribution system. That deliverable is due in February 2026 and based on the options identified we will prioritize next steps on inspections.
